Inspect the platform that exists
A stalled web-to-print build is rarely described consistently. A former supplier may call it almost complete; an estimator may still prepare every quote manually; production may use the MIS while the storefront writes orders to a separate database. A rescue begins by establishing which path actually works, using the code, data and running system the client can lawfully access.
The first deliverable is a plain assessment. It separates implemented behaviour from design intent. We inspect the repository, deployment route, major dependencies, data schema and documented interfaces. We trace a representative product from customer selection through pricing, artwork, order creation and production acknowledgement. A screen that looks finished can hide missing order semantics; a rough screen can sit on a sound domain model. The assessment should say which is true.
Access is a prerequisite. The client must be able to authorise review of the relevant systems, exports and agreements. We do not bypass a licence check or recover material to which the client has no rights. If a previous supplier controls an account or key, that is an ownership and access issue for the client to resolve before a safe migration can be planned.
Decide before rebuilding
The options are not variants of a single sales pitch. Completing the current work may preserve a useful data model and shorten disruption. Replacing one component may remove the bottleneck without touching the MIS. A new platform may be justified when the present design cannot express products or when its dependencies have become untenable. Stopping may be the correct answer when the operational requirement has changed or a packaged product now meets it.
The assessment compares each route against data portability, production interruption, staff retraining, dependency rights, future maintenance and the ability to reverse a cutover. It includes the case against the recommended route. A recommendation to replace everything needs stronger evidence than frustration with a current interface. A recommendation to retain a system must also name the defects the client will still own.
No client is named, logo shown, or work identified on this site without that client's written release. The assessment belongs to the commissioning client; it is not a public case study.

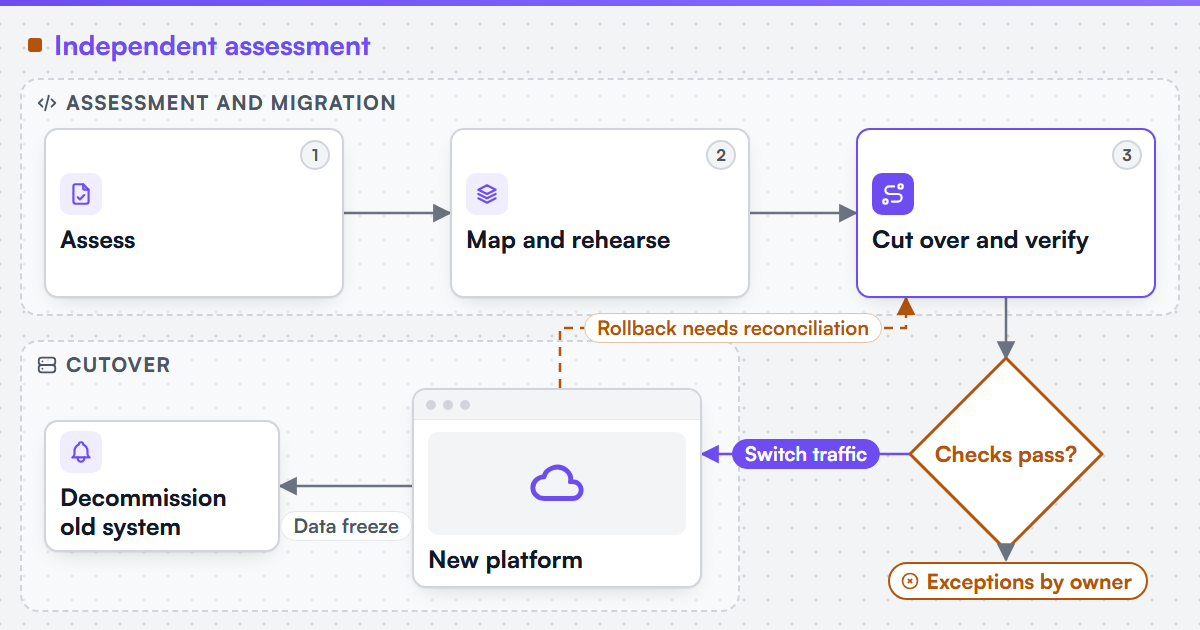

Migration design when it is needed
Migration is an exercise in meaning, not just copying rows. A product option in one system may be encoded as a variant in another. Order status may describe payment in a storefront and production state in an MIS. Artwork references may point to files outside the database. We map those meanings explicitly and keep a record of fields that cannot be carried without a new decision.
Parity tests use representative orders, including awkward cases: reorders, trade pricing, saved designs, partial failures and jobs in progress. We reconcile counts and identifiers, then check samples at the business level. A technically successful import is not enough if a historical order cannot be found, a design opens with the wrong trim size, or production sees two jobs for one purchase.
Cutover planning names the last write on the old system, the data freeze or sync rule, the traffic switch, and the point at which rollback remains possible. It includes who can make that decision and what measurements they will inspect. If the old platform cannot resume safely after a new order is accepted, the plan must say so before release. A public storefront also needs continuity for important URLs and account paths; search redirects and customer communication are part of that work.
What we deliver and exclude
The initial scope is an assessment report with findings, options, risk and a recommendation. If the client commissions migration, the build scope adds the target architecture, field mapping, validation plan, cutover sequence, rollback route, and post-migration checks. Each stage has evidence the client can inspect.
We do not arbitrate a dispute with a prior supplier, provide a legal opinion on past work, warrant code we did not write, or promise to recover data that was never captured. We also do not promise that the inherited system is salvageable. A rescue service is useful only if it can report an unwelcome finding.
Verify the change in production terms
Post-cutover checks should answer the same questions that justified the migration. Can a customer place the representative orders? Does prepress receive the right file? Does the MIS show one job with the right product and production attributes? Can support locate the order and its artwork version? A monitoring dashboard can help, but these direct checks establish whether the user path survived.
The decommissioning plan starts only after the new route is stable. It records which data remains in the old system for lawful retention, which links must keep resolving, who controls old accounts, and when credentials can be withdrawn. Deleting the old environment immediately after a traffic switch can remove the only practical comparison source when a disputed historical job appears.
The client should receive the evidence from reconciliation and the final cutover decision, including known exceptions. A count of migrated database rows is useful but insufficient. The accepted result is that the business can continue estimating, selling, producing and finding its jobs, with exceptions visible to named operators.
Evidence and next step
Web2Print Solutions is a new property. Where we have not yet published a delivered example of a capability, the page says so rather than implying a record.
Read replace the storefront and keep the MIS if that is the suspected boundary. The services directory shows adjacent scopes. A project brief should state what is live, what fails, what access you control, and which decision the assessment must support.
